Welcome Scanclimber part of Alimak Group

Call us

+358 10 680 7000

Monday to Friday

9:00am - 6:00pm

E-mail us

Mülheim-Kärlich nuclear plant demolitionin in Germany

ABB Company constructed the Mülheim-Kärlich nuclear power plant from 1975 to 1986. The plant is located on the Rhine, close to Mülheim-Kärlich, Germany. The plant operated for only three years before taken offline in 1988 because it stood on an earth-quake-prone area.

Background

Court order to decommission the Mülheim-Kärlichnuclear power plant After a lengthy legal battle, the building permit was rescinded in 1995 by court decision and confirmed in 1998.

The plant decommissioning process started in 2001. Removal of the fuel took place one year later. The authorities caused several delays, so the plant and 160-meter cooling tower were still standing in 2018.

Kühlturm in Mülheim-Kärlich fällt

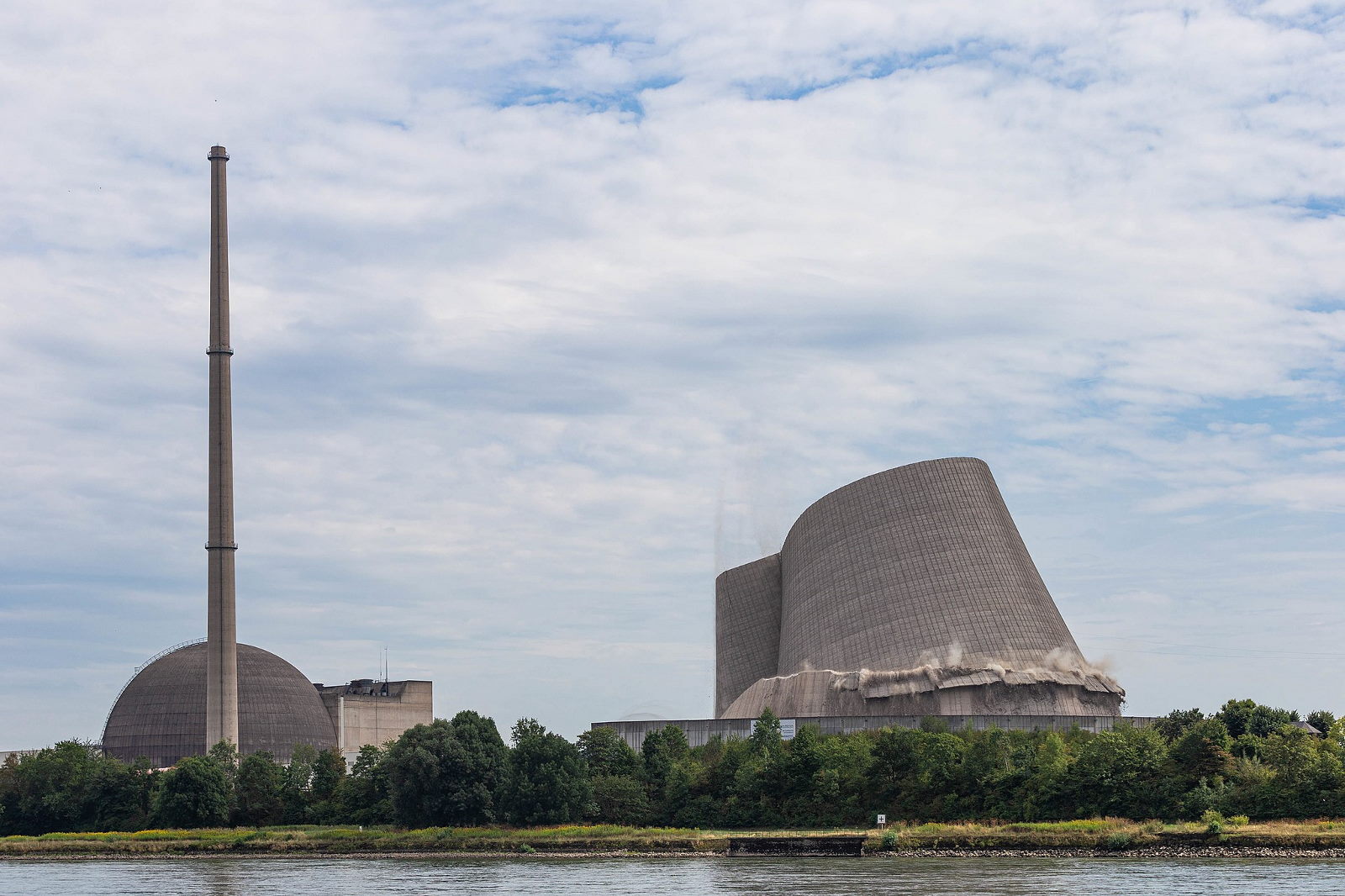

The final demolition of the cooling tower took place on August 9, 2019, at 15.38 local time.

Demolition project

The operator assigned the chimney demolition project to ‘MB Spezialabbruch & Co’from Breitungen.

MB Specialabbruch is a company specializing in the demolition of high-rise structures like chimneys, cooling towers, and the like. They started preparatory work in 2016.

Various conditions and restrictions were laid out for demolition work. Notably, it was forbidden to use explosives in the vicinity of the nuclear facility.

Peter Mittldof, CEO of MB Specialabbruch, thought to use the same technology as in traditional chimney dismantling. It arose from the fact that they had all machines and equipment for conventional chimney dismantling.

They worked on the issue for a long time. The focus was on finding a technical solution that met the authorities’ requirements. The innovation was to use the same techniques as used in traditional chimney decommissioning — a machine right at the work level.

How the demolition was performed

MB Specialabbruch demolished the cooling tower in three phases:

  1. The top layer, at 162 meters, was demolished using standard Brokk demolition robots utilizing a hydraulic hammer.
  2. From the top down to 80 meters, demolition took place with special MB Specialabbruch-built machines, with Scanclimber’s mast climbers supporting the operation. MBSpecialabbruch developed a special construction to lift the RDB100 demolition machine to the demolition zone. In the lifting construction, four winches from Tractel were used. With their help, MB Specialabbruch brought the machine safely up to the top. After preparations, the RDB machine was moved horizontally from the Scanclimbermast climber to the demolition zone to perform the work
  3. The last 80 meters of the chimney was collapsed by removing one of the cooling tower support pillars with a remote-controlled excavator. Before the collapse, the chimney structure was cut into exactly calculated collapsible slices.

Challenges

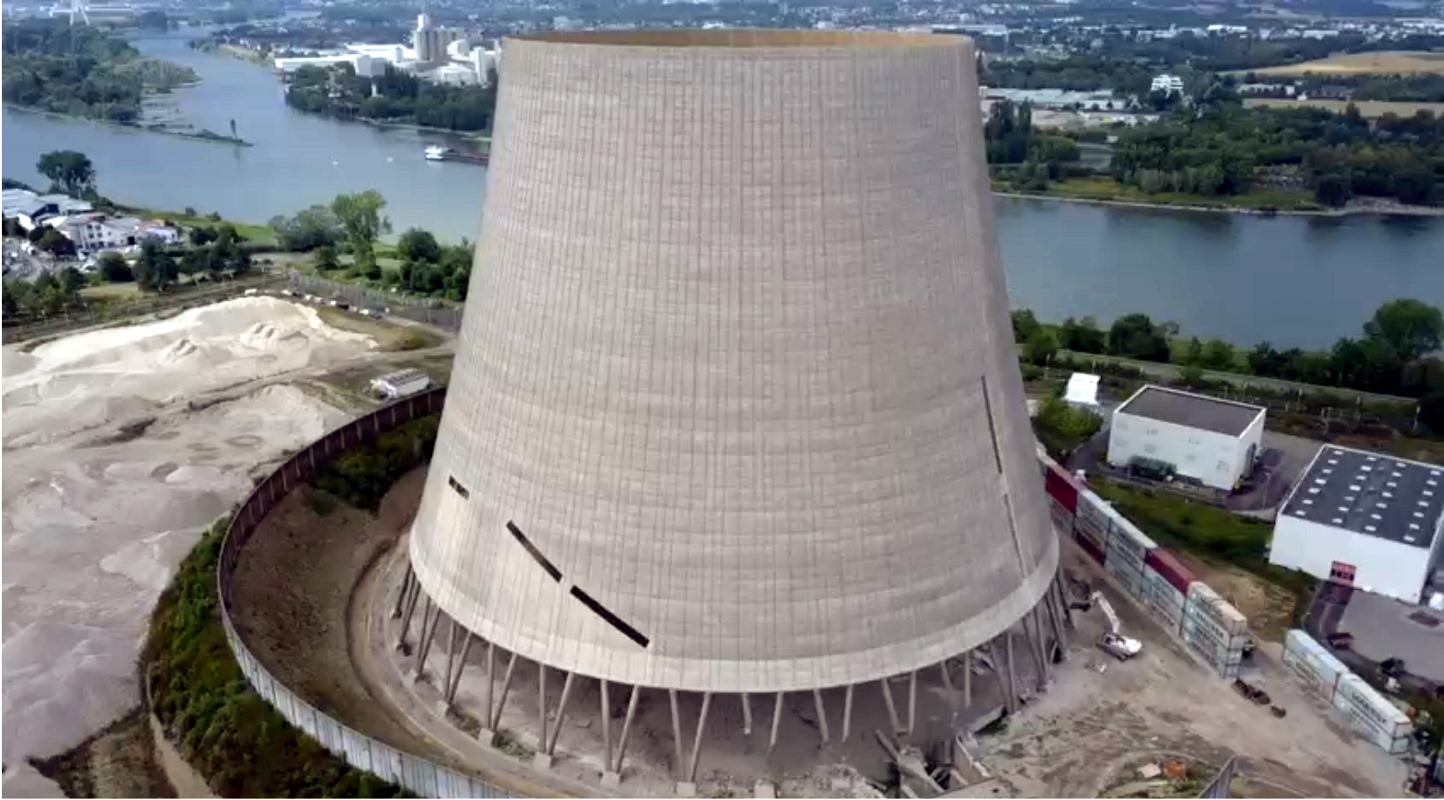

mulheim karlich power plant 01

Dismantling a cooling tower of this size presented several challenges. One of the challenges was to prevent debris from falling on the neighbouring nuclear plant facilities.

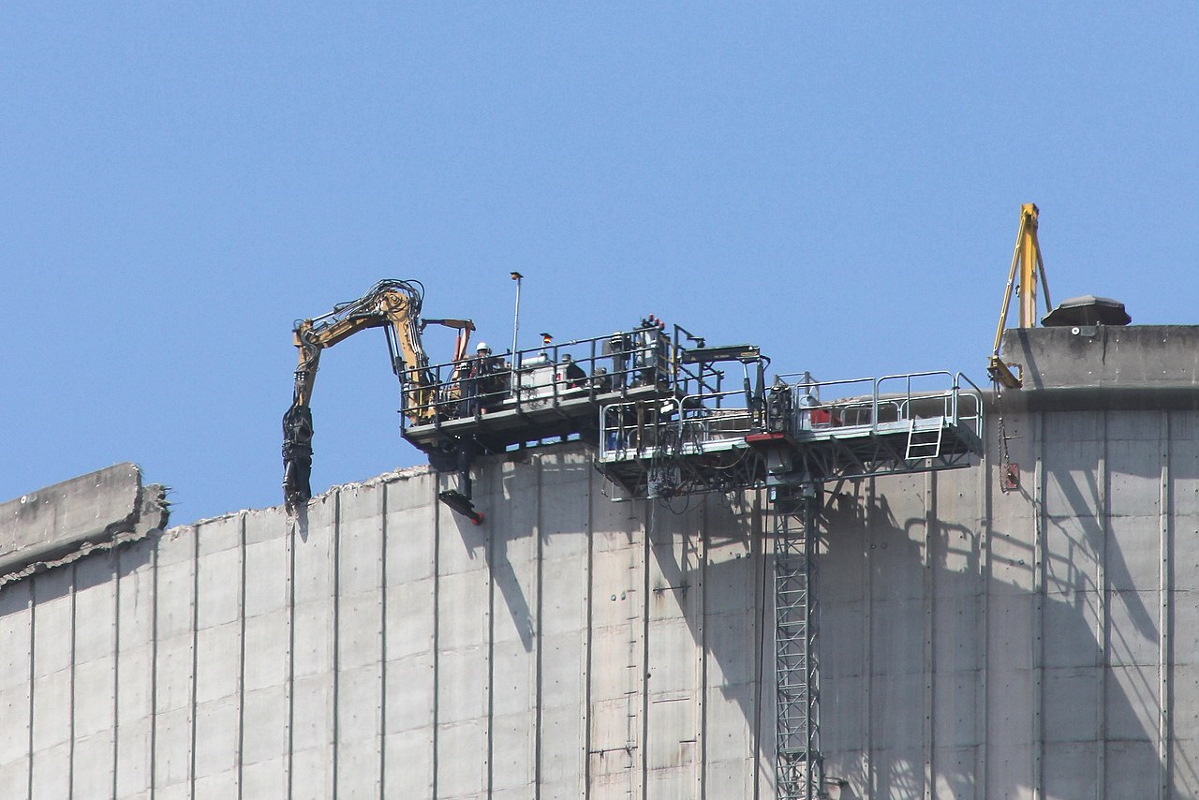

To prevent debris from falling into the adjacent nuclear facility, MB Specialabbruch installed two Scanclimber SC5000 Mast Climbing Work Platforms on opposite sides of the cooling tower. These two machines provided the project support and safe transportation of personnel and materials.

After many difficulties, the demolition of the cooling tower was completed from a height of 163.5 m to 80 m, safely and without accidents.

Finally, on August 9, 2019, the remains of the cooling tower came tumbling down.



Project Facts
Location Mülheim-Kärlich, Germany
Project timelines 2016 – 2019
Height of the cooling tower 162 m
Project type Demolition of a nuclear plant
Machines used SC5000
Main contractor MB Specialabbruch
